Hydro-Québec Accelerates Côte-St-Luc Substation Work After Winter Power Outages
Hydro-Québec Speeds Up Côte-St-Luc Substation Project

Hydro-Québec Accelerates Critical Substation Work Following Major Winter Power Failure

Hydro-Québec announced on Tuesday that it will intensify preparatory efforts for the construction of a new electrical substation in Côte-St-Luc, aiming to enhance power grid reliability for the municipality and surrounding neighborhoods more rapidly. This decision comes in response to a significant outage that left thousands without electricity during the coldest weekend of the year.

Winter Outage Highlights Aging Infrastructure Vulnerabilities

More than 15,000 customers across Côte-St-Luc, Côte-des-Neiges—Notre-Dame-de-Grâce, and Montreal West experienced power disruptions during late January's extreme cold snap. Some residents endured over 48 hours without electricity after a transformer failure at the aging Hampstead substation, which has been operational for approximately 70 years.

The incident underscored the urgent need for infrastructure modernization in the region, particularly as climate patterns bring more frequent extreme weather events that strain existing electrical systems.

Accelerated Timeline for Grid Modernization

While the replacement Côte-St-Luc substation remains scheduled for completion by 2029, Hydro-Québec will now expedite the upgrading of transmission lines connecting the facility to homes and businesses. According to Hydro-Québec spokesman Pascal Poinlane, this involves converting power lines from 12 kilovolts to 25 kilovolts—work that typically occurs only after substation completion and takes four to five years.

"What we're going to do to speed up the process, and to ensure better reliability as quickly as possible, we're going to work on this right now, as we start to build the substation," Poinlane explained. "What we can do to speed up the process is to speed the conversion of the transmission system."

This parallel approach represents a significant acceleration of the overall modernization effort, though businesses and institutions will need to cover the costs of adapting their electrical systems to the higher voltage requirements.

Project History and Current Status

The substation replacement project has been in planning since 2018 but faced delays due to extended public consultation processes and pandemic-related disruptions. Normally, constructing a substation of this scale takes five to eight years, whereas the Côte-St-Luc project will span approximately 11 years from inception to completion.

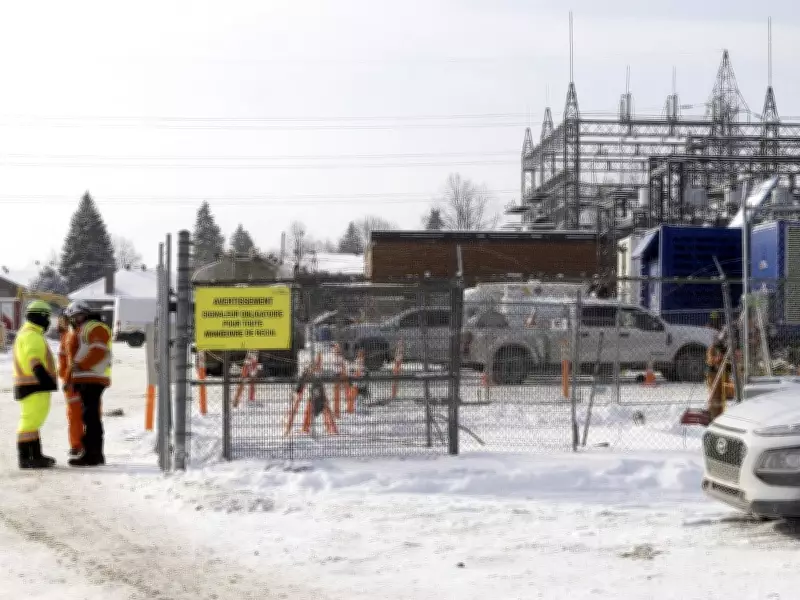

Construction on the new substation is set to begin in June, with crews currently building distribution encasements around the future site and dismantling an unused transmission tower and portion of a 120-kV line. The comprehensive project includes creating an 18-kilometre 312kV line and involves multiple construction sites throughout the affected areas.

Municipal Response and Legal Developments

Local officials have welcomed Hydro-Québec's accelerated timeline while acknowledging the disruptions that construction will bring. Côte-St-Luc Mayor David Tordjman stated, "Following the recent outages that severely affected our citizens, we welcome Hydro-Québec's acceleration of this essential work. Although this large-scale project will require patience, modernization of the grid is an absolute necessity to ensure long-term service reliability."

However, the January outages have also prompted legal action. A Montreal law firm has filed a proposed class action in Quebec Superior Court on behalf of affected residents, alleging that Hydro-Québec failed to provide reliable electrical service to the community.

Broader Infrastructure Investment Context

The Côte-St-Luc substation project represents part of Hydro-Québec's broader $5 billion investment in Montreal island infrastructure upgrades planned through 2035. These improvements aim to address systemic vulnerabilities in the electrical grid while accommodating growing energy demands and increasing resilience against extreme weather events.

With a total project cost of $740 million, the accelerated work on the Côte-St-Luc substation reflects both the utility's response to recent service failures and its commitment to long-term grid modernization across the Montreal region.
