Montage Gold Corp., a prominent gold mining company trading on the TSX and OTCQX, has released its comprehensive activity report for the fourth quarter of 2025, showcasing substantial advancements in both construction and exploration initiatives. The company's flagship Koné project in West Africa is demonstrating remarkable progress, maintaining its position ahead of schedule and within budgetary constraints.
Construction Achievements Exceeding Expectations
The Koné project construction has achieved rapid momentum, with over 9.0 million hours worked to date and more than 3,000 employees and contractors actively engaged on-site. Montage Gold remains firmly on track for its first gold pour through the oxide circuit in late Q4-2026, a significant milestone for the company's operational timeline.
Financial Commitments and Infrastructure Development
As of the reporting date, the company has committed $572.8 million in capital, representing approximately 65% of the total upfront capital expenditure required for the project. This substantial financial commitment underscores the project's advanced stage and the company's confidence in its execution capabilities.

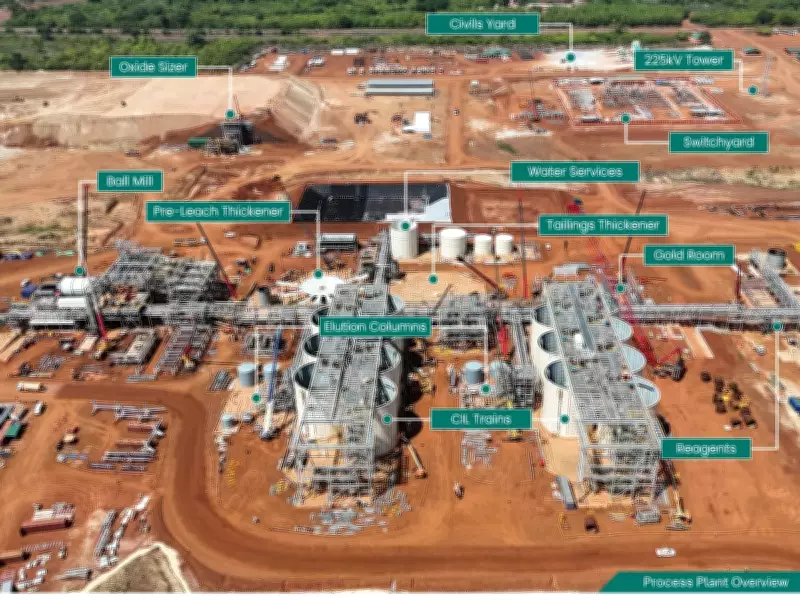

Key process plant achievements include:
- Completion of all Carbon-in-Leach (CIL) tanks
- Successful installation of the ball mill shell
- Finalization of the oxide sizer
- Foundation concrete pours for pre-leach and tailings thickeners
- Significant advancement of the hard-rock comminution circuit
Infrastructure development has progressed exceptionally well, with the river abstraction and water storage facilities now fully operational. The Tailings Storage Facility (TSF) lining is tracking ahead of schedule, relocation activities have been completed, and plant buildings are already fully operational, creating a solid foundation for future production activities.
Exploration Activities Driving Resource Growth
Montage Gold maintained a strong exploration focus throughout 2025, drilling 114,699 meters at the Koné project. This extensive drilling program has primarily targeted the delineation of higher-grade satellite resources that could enhance the project's overall economics and longevity.
Upcoming Resource Updates and New Discoveries
The company has announced that resource updates for both the Koné and Gbongogo Main deposits are expected to be published in the coming weeks. These updates will include detailed information about other deposits along with maiden resource estimates for new discoveries made during recent exploration campaigns.
For 2026, Montage Gold has initiated an ambitious 90,000-meter drilling program that is already well underway. This program represents a continuation of the company's aggressive exploration strategy aimed at expanding known resources and identifying new mineralization zones.
Additionally, the company is conducting a 9,000-meter drilling program at its Wendé advanced greenfield property. This initiative focuses on initial step-out and downdip drilling of historically drilled areas while simultaneously testing new prospective targets that could yield additional mineral resources.
Financial Position and Liquidity Strength
Montage Gold reports a robust financial position with total liquidity and Koné project funding sources amounting to $559.4 million. This substantial financial reserve compares favorably to remaining capital disbursements of $518.0 million, providing the company with a comfortable buffer to complete project construction without financial strain.
Quarterly Performance Metrics
The company's quarterly performance data reveals significant progress across multiple metrics:
- Cumulative hours worked increased by 2.2 million hours from Q3 to Q4 2025
- Total cumulative capital committed rose by $112.6 million during the same period
- Cumulative capital disbursed increased by $104.7 million
- Meters drilled saw a substantial increase of 26,411 meters from Q3 to Q4 2025
- Exploration expenditure grew by $3.4 million quarter-over-quarter
Montage Gold's cash position remains healthy, with cash and cash equivalents reaching $191.8 million at the end of Q4-2025, representing a $32.8 million increase from the previous quarter. The company generated $157.3 million in cash flows from financing activities during the quarter, further strengthening its financial foundation.
The company's Vancouver-based management team expressed satisfaction with the progress achieved during the reporting period, emphasizing that both construction and exploration activities are proceeding according to plan with positive momentum building toward the anticipated first gold pour in late 2026.
